Norman Rogers Drive – Transportation Network Improvements

Roadway rehabilitation and configuration improvements are planned for Norman Rogers Drive in 2026. These enhancements will improve road condition, accessibility, and safety for all road users, including students, families, and local residents.

Find the latest project updates in the News Feed at the bottom of this page.

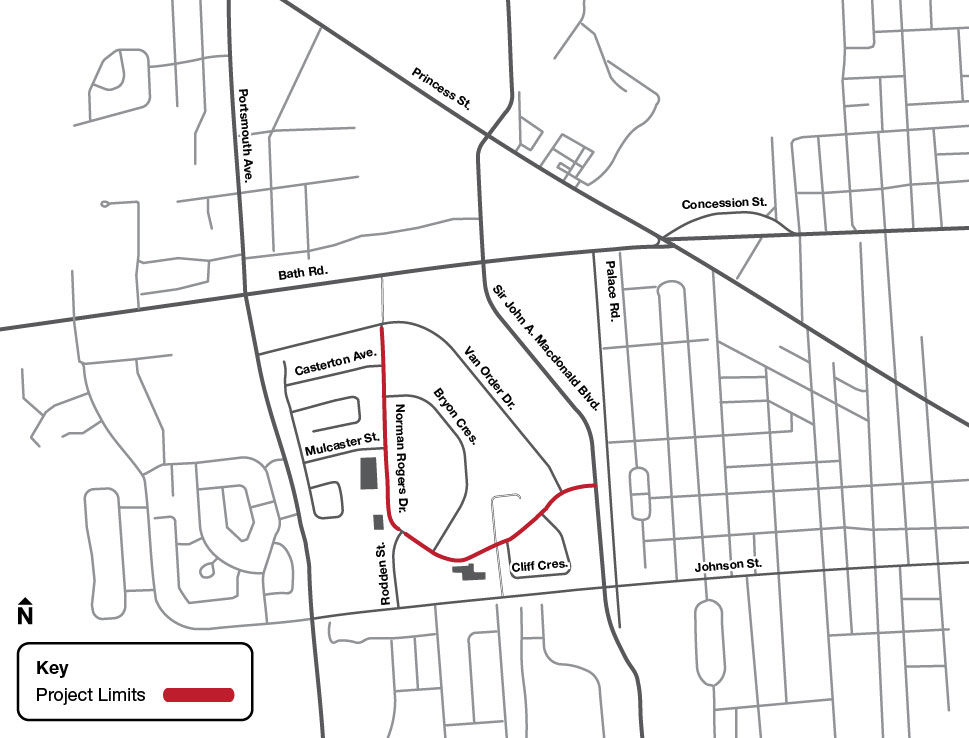

Project location map

A map of the project area

Planned improvements

  • Enhancing pedestrian safety, especially for school children, by using bump-outs, narrowings, and other features to prevent illegal on-street parking and speeding.
  • One at-grade pedestrian crossover in front of St. Thomas More Catholic School.
  • One raised pedestrian crossover at the Norman Rogers Drive and Byron Crescent south intersection.
  • One at-grade pedestrian crossover at the pathway east of Centennial Public School.
  • One at-grade pedestrian crossover at the Norman Rogers Drive and Byron Crescent north intersection.
  • An all-way stop at the Norman Rogers Drive and Van Order Drive east intersection.
  • Full-depth road reconstruction for the entire length of Norman Rogers Drive.
  • Traffic calming measures throughout the corridor including:
    • Curb bump-outs at intersections
    • Narrowing the road width to 8.0m for the length of the road and narrowing further to 6.6m in front of schools.
    • Speed cushions around school zones.
    • Upgrades to the existing storm drainage network

These traffic calming elements are funded through the Investing in Canada Infrastructure Program and the Road Safety Initiatives Fund, which require permanent traffic calming measures to be incorporated into the design. This design for Norman Rogers Drive has been developed in accordance with the City’s Traffic Calming Policy, applicable roadway design guidelines, school area safety standards, and Green Streets principles recently adopted by City Council.

Existing conditions

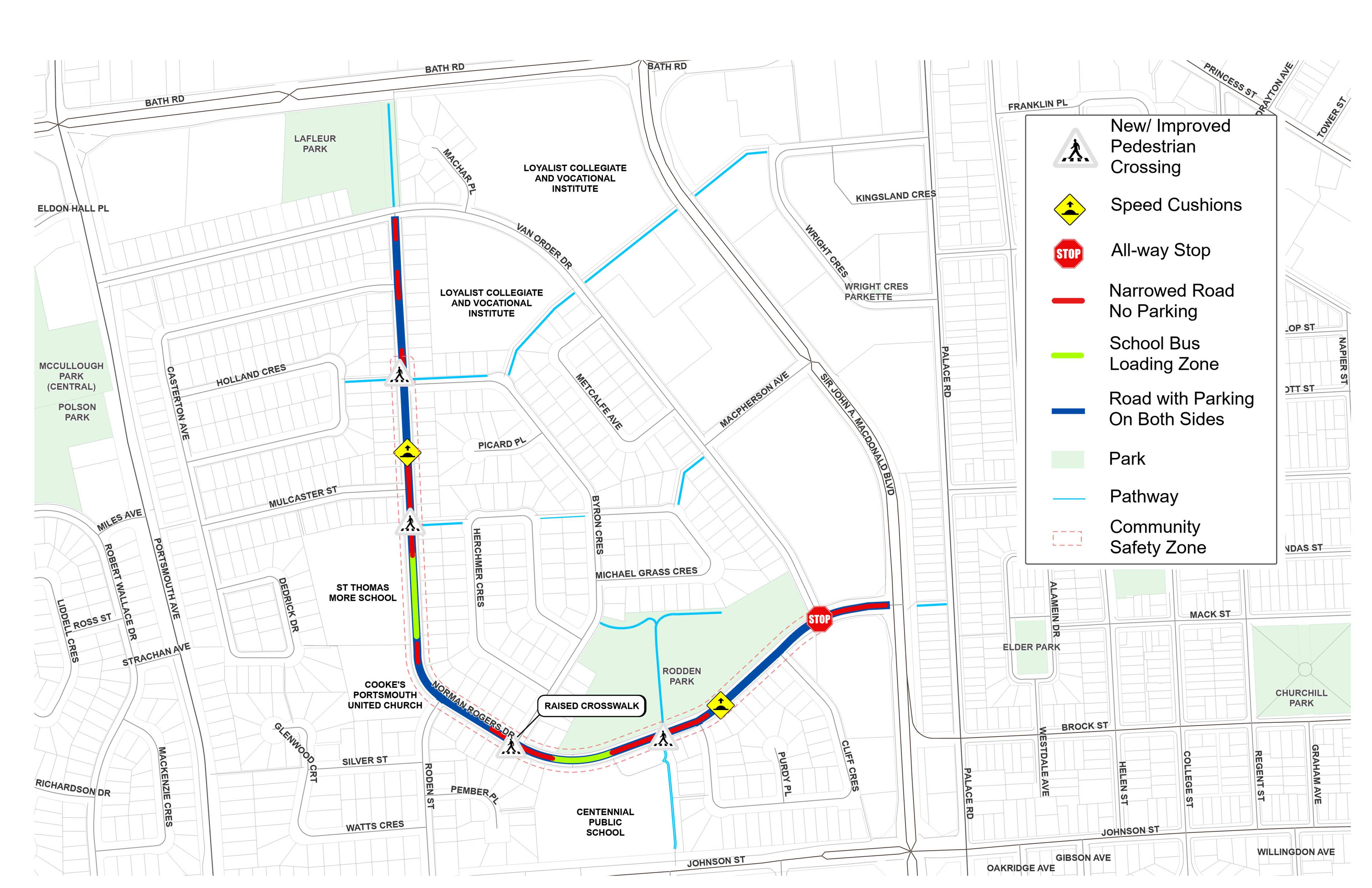

Proposed improvements

Construction impacts

Construction on Norman Rogers Drive is expected to begin Monday, June 15, 2026, with G. Williams Paving as the general contractor.

Access: Due to the excavation required to reconstruct the road, sections of Norman Rogers Drive will be closed during construction. Emergency services and local traffic will have access during road closure operations, however, through-traffic will be restricted. The road will remain open overnight and on weekends.

The contractor is required to provide local access to residents if it is safe to do so. Please tell the attendant at the closure where you need to go and they should provide you with a detour route or instructions on how to access the construction site safely.

Parking: On-street parking may be reduced or not available during portions of construction. Following construction, some parking spaces will be removed at targeted locations along the corridor to accommodate safety improvements, including pedestrian crossings, curb extensions, improved visibility at intersections, and updated roadway design in school areas.

Reductions are limited to specific locations required to accommodate these safety features. Many of the changes occur in areas where parking is already prohibited through signage or operational restrictions, particularly near intersections and school frontages. The design formalizes and reinforces these existing restrictions through physical measures that improve sight lines and crossing safety.

Illegal parking in these locations has created visibility and access concerns for pedestrians, including school children. The proposed curb extensions and clearly defined parking areas help prevent unsafe stopping and parking behaviours that compromise safety.

The majority of on-street parking will remain available. For the existing 55 homes along Norman Rogers, approximately 168 on-street spaces will remain available outside of school hours. On-street parking will continue to be available in proximity to all homes along Norman Rogers Drive, in some cases a short walk away or on the opposite side of the street. Outside of school hours, parking will continue to be permitted within signed school bus loading zones and ‘no stopping – school days only' areas.

These adjustments are necessary to implement funded pedestrian safety and traffic calming measures within the existing right-of-way.

Construction is being planned for summer 2026 to minimize impacts during the school year.

Stay informed

Updates on project progress, construction impacts, and timelines will be shared on this page. Use the Follow Project feature to receive updates by email.

Roadway rehabilitation and configuration improvements are planned for Norman Rogers Drive in 2026. These enhancements will improve road condition, accessibility, and safety for all road users, including students, families, and local residents.

Find the latest project updates in the News Feed at the bottom of this page.

Project location map

A map of the project area

Planned improvements

  • Enhancing pedestrian safety, especially for school children, by using bump-outs, narrowings, and other features to prevent illegal on-street parking and speeding.
  • One at-grade pedestrian crossover in front of St. Thomas More Catholic School.
  • One raised pedestrian crossover at the Norman Rogers Drive and Byron Crescent south intersection.
  • One at-grade pedestrian crossover at the pathway east of Centennial Public School.
  • One at-grade pedestrian crossover at the Norman Rogers Drive and Byron Crescent north intersection.
  • An all-way stop at the Norman Rogers Drive and Van Order Drive east intersection.
  • Full-depth road reconstruction for the entire length of Norman Rogers Drive.
  • Traffic calming measures throughout the corridor including:
    • Curb bump-outs at intersections
    • Narrowing the road width to 8.0m for the length of the road and narrowing further to 6.6m in front of schools.
    • Speed cushions around school zones.
    • Upgrades to the existing storm drainage network

These traffic calming elements are funded through the Investing in Canada Infrastructure Program and the Road Safety Initiatives Fund, which require permanent traffic calming measures to be incorporated into the design. This design for Norman Rogers Drive has been developed in accordance with the City’s Traffic Calming Policy, applicable roadway design guidelines, school area safety standards, and Green Streets principles recently adopted by City Council.

Existing conditions

Proposed improvements

Construction impacts

Construction on Norman Rogers Drive is expected to begin Monday, June 15, 2026, with G. Williams Paving as the general contractor.

Access: Due to the excavation required to reconstruct the road, sections of Norman Rogers Drive will be closed during construction. Emergency services and local traffic will have access during road closure operations, however, through-traffic will be restricted. The road will remain open overnight and on weekends.

The contractor is required to provide local access to residents if it is safe to do so. Please tell the attendant at the closure where you need to go and they should provide you with a detour route or instructions on how to access the construction site safely.

Parking: On-street parking may be reduced or not available during portions of construction. Following construction, some parking spaces will be removed at targeted locations along the corridor to accommodate safety improvements, including pedestrian crossings, curb extensions, improved visibility at intersections, and updated roadway design in school areas.

Reductions are limited to specific locations required to accommodate these safety features. Many of the changes occur in areas where parking is already prohibited through signage or operational restrictions, particularly near intersections and school frontages. The design formalizes and reinforces these existing restrictions through physical measures that improve sight lines and crossing safety.

Illegal parking in these locations has created visibility and access concerns for pedestrians, including school children. The proposed curb extensions and clearly defined parking areas help prevent unsafe stopping and parking behaviours that compromise safety.

The majority of on-street parking will remain available. For the existing 55 homes along Norman Rogers, approximately 168 on-street spaces will remain available outside of school hours. On-street parking will continue to be available in proximity to all homes along Norman Rogers Drive, in some cases a short walk away or on the opposite side of the street. Outside of school hours, parking will continue to be permitted within signed school bus loading zones and ‘no stopping – school days only' areas.

These adjustments are necessary to implement funded pedestrian safety and traffic calming measures within the existing right-of-way.

Construction is being planned for summer 2026 to minimize impacts during the school year.

Stay informed

Updates on project progress, construction impacts, and timelines will be shared on this page. Use the Follow Project feature to receive updates by email.

  • Project update - Sept. 9, 2026

    To assist with the transition into the school year, our contracting partner will be delaying their closure between Van Order Drive and Mulcaster Street until further restoration work is completed for the rest of Norman Rogers Drive. Full closure of Norman Rogers Drive is expected to begin as early as Sept. 14, between Mulcaster Street and Van Order Drive.

    The general construction schedule is expected to proceed as follows:

    • Sept. 8-11
      • No full closures on Norman Rogers Drive.
      • Crews will be completing restoration work and sign installation south of Mulcaster Street.
      • The road will be reduced to one lane where crews are working, with personnel on site to direct traffic.
    • Sept. 14-18
      • Curb and sidewalk installation from Mulcaster Street to Van Order Drive.
      • Full closure between Mulcaster Street and Van Order Drive with access for local traffic only.
    • Sept. 21-25
      • Paving base asphalt from Mulcaster Street to Van Order Drive.
      • Full closure between Mulcaster Street and Van Order Drive with access for local traffic only.
    • Sept. 28-29: Surface Paving for full length of Norman Rogers Drive and installation of speed cushions and raised crossing.
    • Sept. 30 - Oct. 9: Site restoration and cleanup.

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

    To assist with the transition into the school year, our contracting partner will be delaying their closure between Van Order Drive and Mulcaster Street until further restoration work is completed for the rest of Norman Rogers Drive. Full closure of Norman Rogers Drive is expected to begin as early as Sept. 14, between Mulcaster Street and Van Order Drive.

    The general construction schedule is expected to proceed as follows:

    • Sept. 8-11
      • No full closures on Norman Rogers Drive.
      • Crews will be completing restoration work and sign installation south of Mulcaster Street.
      • The road will be reduced to one lane where crews are working, with personnel on site to direct traffic.
    • Sept. 14-18
      • Curb and sidewalk installation from Mulcaster Street to Van Order Drive.
      • Full closure between Mulcaster Street and Van Order Drive with access for local traffic only.
    • Sept. 21-25
      • Paving base asphalt from Mulcaster Street to Van Order Drive.
      • Full closure between Mulcaster Street and Van Order Drive with access for local traffic only.
    • Sept. 28-29: Surface Paving for full length of Norman Rogers Drive and installation of speed cushions and raised crossing.
    • Sept. 30 - Oct. 9: Site restoration and cleanup.

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

  • Project update - Sept. 2, 2026

    To assist with the transition into the school year, our contracting partner will be delaying their closure between Van Order Drive and Byron Crescent until further restoration work is completed for the rest of Norman Rogers Drive.

    The general construction schedule is expected to proceed as follows:

    • Sept. 2-8 - Start of the school year
      • No full closures on Norman Rogers Drive.
      • The road will be reduced to one lane where crews are working, with personnel on site to direct traffic.
    • Sept. 9-18
      • Curb and sidewalk installation from Mulcaster Street to Van Order Drive.
      • Paving base asphalt from Mulcaster Street to Van Order Drive.
    • Sept. 21-22
      • Surface paving for full length of Norman Rogers Drive and installation of speed cushions and raised crossing.
    • Sept. 23-30
      • Site restoration and cleanup.

    Please note that all dates are subject to change based on weather conditions and construction progress.

    To assist with the transition into the school year, our contracting partner will be delaying their closure between Van Order Drive and Byron Crescent until further restoration work is completed for the rest of Norman Rogers Drive.

    The general construction schedule is expected to proceed as follows:

    • Sept. 2-8 - Start of the school year
      • No full closures on Norman Rogers Drive.
      • The road will be reduced to one lane where crews are working, with personnel on site to direct traffic.
    • Sept. 9-18
      • Curb and sidewalk installation from Mulcaster Street to Van Order Drive.
      • Paving base asphalt from Mulcaster Street to Van Order Drive.
    • Sept. 21-22
      • Surface paving for full length of Norman Rogers Drive and installation of speed cushions and raised crossing.
    • Sept. 23-30
      • Site restoration and cleanup.

    Please note that all dates are subject to change based on weather conditions and construction progress.

  • Project update - Aug. 26, 2026

    In preparation for the start of the school year, our contracting partner is working to finish as much work near the schools on Norman Rogers Drive as possible; however, construction on Norman Rogers Drive is expected to continue for the first few weeks of September.

    Closures are expected from Van Order Drive to Byron Crescent. Through traffic will not be permitted except for emergency vehicles and school buses. Local residents can ask the attendant for access, and they will provide instructions for safe navigation in the work zone.

    The general construction schedule is expected to proceed as follows:

    August 26-27: Curb and sidewalk installation from Roden Street to Byron Crescent (north)

    August 28: Paving from Byron Crescent (south) to Mulcaster Street

    August 31 - September 1: Driveway restoration and signage installation from Byron Crescent (south) to Byron Crescent (north)

    September 2-4 - Start of the school year: Curb and sidewalk installation from Byron Crescent (north) to Van Order Drive. Through traffic will not be permitted for this closure. Parents are encouraged to use the church parking lot at 200 Norman Rogers Drive for pick-up and drop-off, or to loop around using Byron Crescent and approach the school from the north.

    September 7-11

    • Curb and sidewalk installation from Byron Crescent (north) to Van Order Drive
    • Paving base asphalt from Mulcaster Street to Van Order Drive

    September 14-15: Surface paving for full length of Norman Rogers Drive and installation of speed cushions

    September 16-24: Site restoration and cleanup

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

    In preparation for the start of the school year, our contracting partner is working to finish as much work near the schools on Norman Rogers Drive as possible; however, construction on Norman Rogers Drive is expected to continue for the first few weeks of September.

    Closures are expected from Van Order Drive to Byron Crescent. Through traffic will not be permitted except for emergency vehicles and school buses. Local residents can ask the attendant for access, and they will provide instructions for safe navigation in the work zone.

    The general construction schedule is expected to proceed as follows:

    August 26-27: Curb and sidewalk installation from Roden Street to Byron Crescent (north)

    August 28: Paving from Byron Crescent (south) to Mulcaster Street

    August 31 - September 1: Driveway restoration and signage installation from Byron Crescent (south) to Byron Crescent (north)

    September 2-4 - Start of the school year: Curb and sidewalk installation from Byron Crescent (north) to Van Order Drive. Through traffic will not be permitted for this closure. Parents are encouraged to use the church parking lot at 200 Norman Rogers Drive for pick-up and drop-off, or to loop around using Byron Crescent and approach the school from the north.

    September 7-11

    • Curb and sidewalk installation from Byron Crescent (north) to Van Order Drive
    • Paving base asphalt from Mulcaster Street to Van Order Drive

    September 14-15: Surface paving for full length of Norman Rogers Drive and installation of speed cushions

    September 16-24: Site restoration and cleanup

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

  • Project update - July 31, 2026

    The general construction schedule is expected to proceed as follows:

    • August 4 - 21
      • Full road closures from Byron Crescent (south) to Van Order Drive for excavation of the existing road.
        • Local and emergency vehicle access will be maintained throughout.
    • August 10-18
      • Road reconstruction and curb installation from Byron Crescent (south) to Mulcaster Street.
    • August 19-31
      • Road reconstruction and curb installation from Mulcaster Street to Van Order Drive.
    • September 1-14
      • Final restoration and surface paving for the full length of Norman RogersDrive.
        • School pick-up and drop-off operations will be maintained during construction.
    • September 15-24
      • Site cleanup

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

    The general construction schedule is expected to proceed as follows:

    • August 4 - 21
      • Full road closures from Byron Crescent (south) to Van Order Drive for excavation of the existing road.
        • Local and emergency vehicle access will be maintained throughout.
    • August 10-18
      • Road reconstruction and curb installation from Byron Crescent (south) to Mulcaster Street.
    • August 19-31
      • Road reconstruction and curb installation from Mulcaster Street to Van Order Drive.
    • September 1-14
      • Final restoration and surface paving for the full length of Norman RogersDrive.
        • School pick-up and drop-off operations will be maintained during construction.
    • September 15-24
      • Site cleanup

    Please note that all dates are subject to change based on weather conditions and construction progress.

    For up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

  • Project update - July 6, 2026

    The contractor has completed removal of the existing pavement from Sir John A MacDonald Blvd. to Cliff Cres. (west), and we are progressing with storm system upgrades between Roden St. and Van Order Dr.

    The general construction schedule is expected to proceed as follows:

    • July 6-17
      • Full road closures from Roden St. to Van Order Dr. for installation of catch basins and storm sewer.
      • Half closures from Cliff St. (west) to Byron Cres. for road reconstruction.
    • July 20-31
      • Full road closures from Sir John A MacDonald Blvd. to Roden St. for curb installation and paving.
    • August 2026
      • Road reconstruction from Roden St. to Byron Cres. (north)
    • September 2026
      • Road reconstruction from Byron Cres. (north) to Van Order Dr.

    Please note that all dates are subject to change based on weather conditions and construction progress.

    To view up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

    The contractor has completed removal of the existing pavement from Sir John A MacDonald Blvd. to Cliff Cres. (west), and we are progressing with storm system upgrades between Roden St. and Van Order Dr.

    The general construction schedule is expected to proceed as follows:

    • July 6-17
      • Full road closures from Roden St. to Van Order Dr. for installation of catch basins and storm sewer.
      • Half closures from Cliff St. (west) to Byron Cres. for road reconstruction.
    • July 20-31
      • Full road closures from Sir John A MacDonald Blvd. to Roden St. for curb installation and paving.
    • August 2026
      • Road reconstruction from Roden St. to Byron Cres. (north)
    • September 2026
      • Road reconstruction from Byron Cres. (north) to Van Order Dr.

    Please note that all dates are subject to change based on weather conditions and construction progress.

    To view up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

  • Project update - June 2, 2026

    The contractor has been locating utilities and completing preparation work during May. Construction on Norman Rogers Drive is expected to begin Monday, June 15, 2026 (please note this has been updated from an earlier date).

    The general closure schedule is expected to proceed as follows:

    • June 2026 – Sir John A Macdonald Boulevard to Cliff Crescent (west)
      • Access to Norman Rogers Drive from Sir John A Macdonald Boulevard will be closed during working hours.
    • July 2026 - Cliff Crescent (west) to Roden Street
    • August 2026 – Roden Street to Byron Crescent (north)
    • September 2026 – Byron Crescent (north) to Van Order Drive

    Please note that all dates are subject to change based on weather conditions and construction progress. To view up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

    The contractor has been locating utilities and completing preparation work during May. Construction on Norman Rogers Drive is expected to begin Monday, June 15, 2026 (please note this has been updated from an earlier date).

    The general closure schedule is expected to proceed as follows:

    • June 2026 – Sir John A Macdonald Boulevard to Cliff Crescent (west)
      • Access to Norman Rogers Drive from Sir John A Macdonald Boulevard will be closed during working hours.
    • July 2026 - Cliff Crescent (west) to Roden Street
    • August 2026 – Roden Street to Byron Crescent (north)
    • September 2026 – Byron Crescent (north) to Van Order Drive

    Please note that all dates are subject to change based on weather conditions and construction progress. To view up-to-date information about road and sidewalk closures and other traffic disruptions as a result of road work, visit Municipal511.ca.

Page last updated: 09 Sep 2026, 02:47 PM
